Germany accelerates MEKO A-200 frigate acquisition to avoid naval capability gap by 2029.
Germany's Bundestag budget committee authorized accelerated preparatory measures for the acquisition of MEKO A-200 DEU anti-submarine warfare frigates, formalizing a shift to preserve naval capability timelines and sustain anti-submarine warfare readiness.
The decision enables advance procurement actions and shipyard preparation to ensure the German Navy can field new platforms before a projected capability gap emerges by 2029 as part of NATO maritime commitments. This move offsets delays in the F126 program and reinforces Germany’s ability to maintain operational presence and deterrence in critical areas such as the North Atlantic and GIUK corridor.
Read also: Germany to receive first MEKO A-200 DEU frigate from TKMS in 2029 to offset F-126 delays

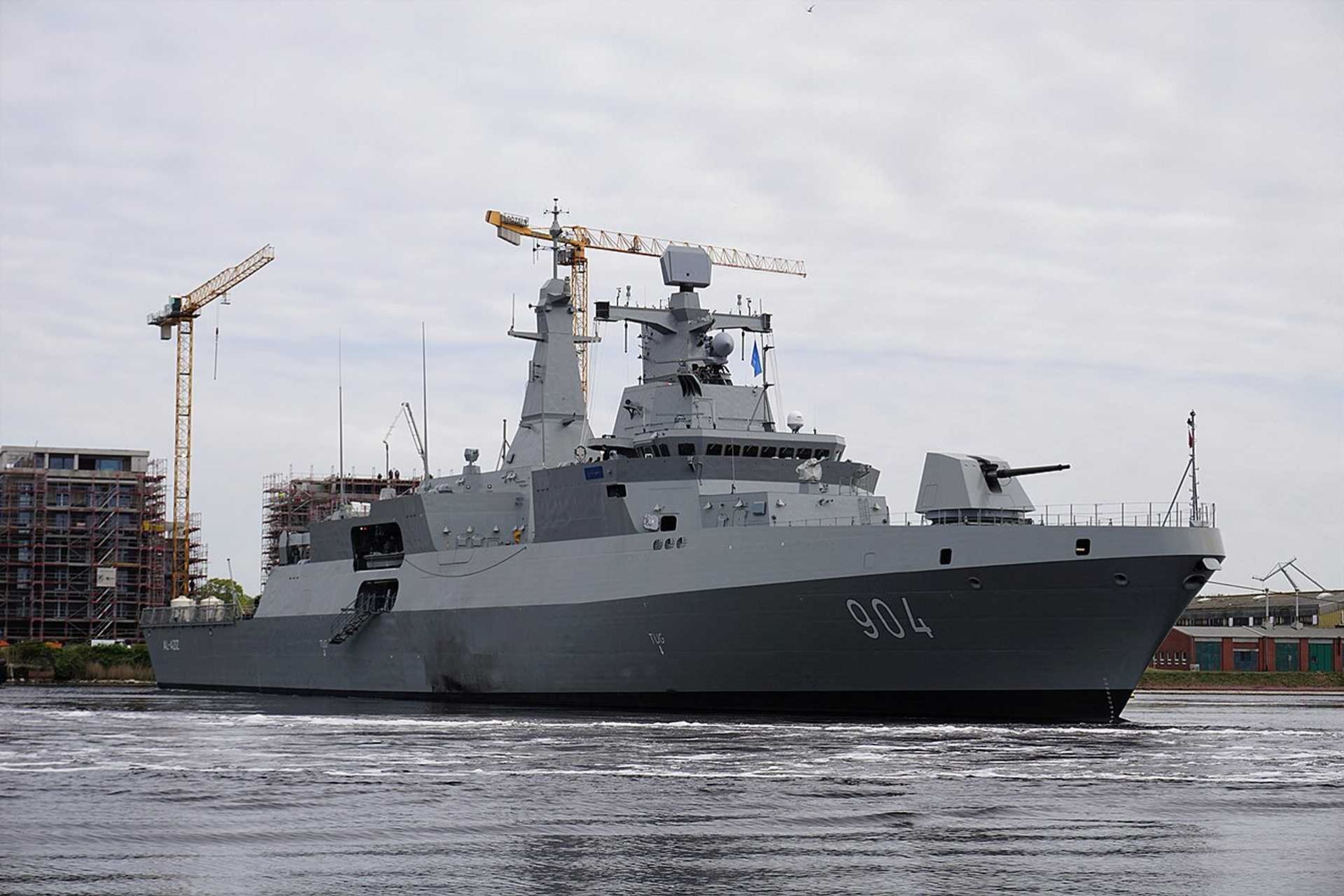

The MEKO A-200 frigate’s configuration allows the integration of various combat systems depending on national requirements, including vertical launch systems, anti-ship missiles, naval guns, and sonar suites. (Picture source: Wikimedia/Ein Dahmer)
On March 18, 2026, Germany's Bundestag budget committee authorized accelerated preparatory measures for the acquisition of MEKO A-200 DEU anti-submarine warfare frigates, formalizing a shift in planning driven by delays in the F126 program. To sustain operational readiness within required timelines, the committee approved an amendment to an existing preliminary agreement, extending industrial activities until June 30, 2026, ahead of a final construction contract. This decision includes the allocation of €240 million from the Bundeswehr special fund to secure production continuity and preserve delivery schedules. The measure enables early procurement actions, including material orders, supplier engagement, and reservation of shipyard capacity.
The objective is to maintain the option of delivering the first unit by December 2029, to avoid capability gaps for the German Navy, as part of broader NATO expectations regarding maritime security contributions from member states. The need for this parallel procurement is driven by significant disruptions affecting the F126 frigate program, initially intended to deliver six ships from 2028 onward, with later units planned through 2034. The program has accumulated at least four years of delay due to multiple technical and organizational challenges. Among the most critical issues are difficulties in transferring construction data between digital systems used by the original Dutch prime contractor and subcontractors.
These difficulties disrupted the detailed design phase and delayed construction readiness across multiple shipyards and suppliers, requiring rework and system adaptation. As a result, projected delivery dates have shifted toward 2031 or later for initial units. Financial exposure has already reached approximately €2 billion without corresponding physical output. These delays have created uncertainty regarding both the schedule and final cost of a program initially planned as the primary solution for Germany's future naval capabilities. To mitigate these risks, the German Ministry of Defence implemented a dual-track procurement structure combining the F126 program continuation with the acquisition of MEKO A-200 frigates.
This approach maintains contractual engagement with existing partners while establishing an alternative delivery path based on an available design. Negotiations are ongoing regarding a potential change of industrial leadership within the F126 program, including the involvement of a new general contractor. At the same time, preparatory activities for the MEKO program proceed to secure timelines independently of F126 outcomes. The dual-track method is structured to preserve optionality while ensuring that naval capability requirements are not delayed further. It allows decision makers to defer final program prioritization while maintaining industrial momentum. This structure, for now, reflects more a risk management approach rather than a program replacement.
The Ministry plans the procurement of four MEKO A-200 frigates as an initial batch, with options under consideration for additional units depending on developments in the F126 program. Budget planning allows for up to eight ships if the original program is reduced or terminated. Unit cost estimates range between €0.5 billion and €1 billion, depending on configuration, resulting in a potential total program value of up to €8 billion for eight ships. Current financial planning includes €724.7 million allocated in 2026, €878.2 million in commitment authority for 2027, and approximately €6.2 billion from 2028 onward through 2033. The procurement is intended to ensure that new ships enter service starting in 2029, aligning with previous operational requirements.
The vessels are expected to operate in the North Atlantic, particularly in the Greenland-Iceland-UK corridor, a region critical for NATO logistics and submarine monitoring. The preliminary agreement signed in early February 2026 between the Bundeswehr procurement authority and Thyssenkrupp Marine Systems (TKMS) established the industrial base for the MEKO A-200 DEU program. The agreement initially covered up to €50 million in preparatory work through March 2026, including procurement of long-lead materials and initiation of steel cutting. It also enabled reservation of production slots across the supplier network, including companies such as Ostseestahl, Renk, Stahlbau Nord, and Noske-Kaeser.
The agreement can be extended incrementally if a final construction contract is not yet concluded. The extension approved in March increases financial scope and ensures continuity of industrial activity until June 30, 2026. This mechanism reduces the risk of production delays caused by contractual gaps, while also allowing an immediate transition to full production once a binding contract is signed. The MEKO A-200 DEU frigate is based on a modular warship design developed for multirole operations, with emphasis on antisubmarine warfare, surface combat, and maritime security missions. The vessel has a length of 121 meters, a beam of 16.4 meters, and a full-load displacement of approximately 3,950 tons.
Propulsion is provided by a CODAG-WARP configuration combining two 6 MW diesel engines with a 20 MW gas turbine driving a central waterjet, enabling speeds exceeding 29 knots. The operational range exceeds 6,500 nautical miles at a cruising speed of 16 knots. The ship accommodates a core crew of about 125 personnel with capacity for additional embarked forces. Aviation facilities support either two helicopters in the 6-ton class or one 11-ton helicopter, along with unmanned aerial systems. The design includes reduced acoustic, infrared, and radar signatures to support antisubmarine operations. The ship’s configuration allows integration of various combat systems depending on national requirements, including vertical launch systems, anti-ship missiles, naval guns, and sonar suites.
Export variants have demonstrated configurations with 127 mm naval guns, 32-cell vertical launch systems, and multiple anti-ship missile launchers. The hull design incorporates an X-form geometry to reduce radar cross-section, while exhaust systems are routed to minimize infrared emissions. Acoustic signature reduction is achieved through machinery isolation and propulsion layout optimization. Survivability is enhanced by a compartmentalized hull with independent power and firefighting systems. The design also includes active stabilizers and a forefoot skeg to improve seakeeping and operational stability. These characteristics enable sustained operations in sea state 6 conditions.
The current procurement trajectory reflects a requirement to balance delivery timelines, cost constraints, and operational capability under conditions of industrial uncertainty. The MEKO A-200 program provides a near-term solution with defined delivery targets, while the F126 program remains subject to restructuring and schedule revision. Both programs continue in parallel, with final decisions dependent on industrial performance, contractual outcomes, and budgetary considerations. The emphasis remains on ensuring that antisubmarine warfare capabilities are available within the required timeframe. The approach prioritizes readiness and schedule certainty over long-term program consolidation. This dual structure is expected to remain in place until a definitive procurement decision is reached.
Written by Jérôme Brahy
